| Valaris Limited | ||||||||
| November 1, 2023 | /s/ CHRISTOPHER T. WEBER | |||||||
Christopher T. Weber Senior Vice President and Chief Financial Officer | ||||||||

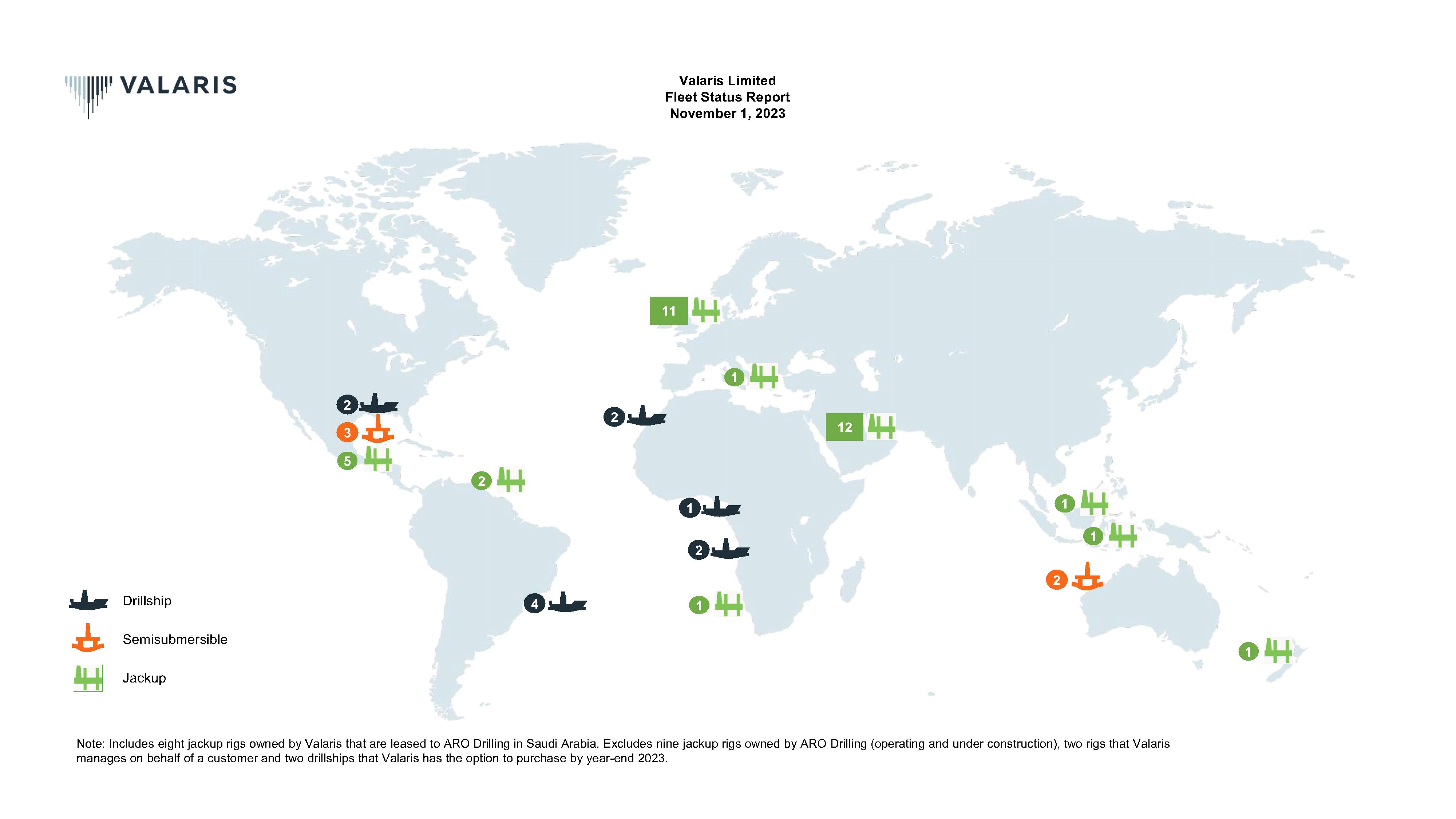

![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| New Contracts and Extensions, Rig Sales and Other Updates Since Last Fleet Status Report | ||
Contract Backlog •Valaris has been awarded the following new contracts and contract extensions, with associated contract backlog of approximately $480 million, subsequent to issuing its most recent fleet status report on August 1, 2023. Contract backlog excludes lump sum payments such as mobilization fees and capital reimbursements. •Contract backlog increased to approximately $3.2 billion from approximately $3.0 billion as of August 1, 2023. Floaters •250-day contract extension with TotalEnergies offshore Brazil for drillship VALARIS DS-15. The extension period is expected to commence in the fourth quarter 2024 in direct continuation of the rig's current program. The total contract value for the firm period, excluding the provision of MPD and additional services, is $100 million. An additional rate will be charged for MPD and any other additional services when provided. The contract includes two 160-day priced options and one 120-day priced option, with increased operating day rates for each option period. The total contract value for the option periods if exercised, excluding the provision of MPD and additional services, is approximately $210 million. An additional rate will be charged for MPD and any other additional services when provided. •Six-month priced option exercised by Petrobras offshore Brazil for drillship VALARIS DS-4. The six-month option will commence in January 2024 in direct continuation of the existing firm program. The priced option period has an estimated total contract value of approximately $41 million. •Six-month priced contract extension with ExxonMobil offshore Angola for drillship VALARIS DS-9. The six-month extension will commence in July 2024 in direct continuation of the existing firm program. •Two-well contract with Eni Mexico S. de R.L. de C.V. offshore Mexico for semisubmersible VALARIS DPS-5. The contract is expected to commence in March 2024 and has a minimum duration of 110 days. The operating day rate is $345,000, plus a $3 million mobilization fee. •One-well contract with BP offshore Brazil for drillship VALARIS DS-15. The contract is expected to commence in late first quarter or early second quarter 2024 in direct continuation of the rig's current program, with TotalEnergies, and has an estimated duration of 80 days. The estimated contract value is approximately $33 million and excludes payments we will receive for mobilization and any additional services. •A previously disclosed exercised priced option with TotalEnergies offshore Brazil for drillship VALARIS DS-15 is now expected to be undertaken in direct continuation of the aforementioned BP contract. The option period is expected to commence in late second quarter or early third quarter 2024 and has an estimated duration of 100 days. The operating day rate for the option period is approximately $254,000. The contract backlog for this previously disclosed contract is not included in the $480 million of additional backlog mentioned above. Jackups •55-well plug and abandonment (P&A) contract with Eni in the East Irish Sea (UK) for standard duty legacy jackup VALARIS 72. The contract is expected to commence in December 2023 and has an estimated duration of nearly four years (1,346 days). The operating day rate is subject to a market-indexed annual adjustment. VALARIS Norway will substitute for VALARIS 72 until VALARIS 72 completes its current contract with Eni in the UK North Sea, which is expected to finish in December 2024. •Six-well contract extension with BP Trinidad for heavy duty modern jackup VALARIS 118. The extension period is expected to commence in March 2024, in direct continuation of the existing firm program, and has an estimated duration of one year. The extension period has an estimated total contract value of approximately $51 million. •Six-well contract with TAQA on the Porthos Carbon Capture and Storage (CCS) program in the Dutch North Sea for heavy duty harsh environment jackup VALARIS 123. The contract is expected to commence in fourth quarter 2024 and has a minimum duration of 170 days. The contract includes options for up to 10 wells with an estimated total duration of 300 days. The operating day rate is $142,500, increasing to $152,500 effective January 1, 2025 and $162,500 effective January 1, 2026. •Heavy duty ultra-harsh environment jackup VALARIS 249 has been contracted by Perenco T&T Limited to drill one open-water appraisal well in the TSP block, offshore the southeast coast of Trinidad. The contract is expected to commence in second half 2024, in direct continuation of the rig's current program with another operator. •Five-well priced option exercised by BP Indonesia for heavy duty modern jackup VALARIS 106. The option period is expected to commence in January 2024, in direct continuation of the existing firm program and has an estimated duration of 365 days. The operating day rate is $85,000 effective from January 6, 2024, increasing to $95,000 from January 6, 2025. As previously disclosed, the rig is expected to be out of service for approximately 90 days for planned maintenance across second quarter and third quarter 2024. | ||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
Contract Backlog(1) (2) ($ millions) | 2023 | 2024 | 2025+ | Total | Contracted Days(1) (2) | 2023 | 2024 | 2025+ | |||||||||||||||||||||
| Drillships | $ | 113.2 | $ | 894.9 | $ | 718.4 | $ | 1,726.5 | Drillships | 434 | 2,760 | 1,848 | |||||||||||||||||
| Semisubmersibles | 38.9 | 194.5 | 26.1 | 259.5 | Semisubmersibles | 171 | 798 | 116 | |||||||||||||||||||||
| Floaters | $ | 152.1 | $ | 1,089.4 | $ | 744.5 | $ | 1,986.0 | Floaters | 605 | 3,558 | 1,964 | |||||||||||||||||
| HD - Ultra-Harsh & Harsh | $ | 43.9 | $ | 223.2 | $ | 60.8 | $ | 327.9 | HD - Ultra-Harsh & Harsh | 396 | 1,920 | 445 | |||||||||||||||||
| HD & SD - Modern | 36.9 | 212.9 | 157.0 | 406.8 | HD & SD - Modern | 406 | 2,057 | 1,285 | |||||||||||||||||||||
| SD - Legacy | 8.9 | 58.2 | 119.8 | 186.9 | SD - Legacy | 120 | 732 | 1,359 | |||||||||||||||||||||
| Jackups | $ | 89.7 | $ | 494.3 | $ | 337.6 | $ | 921.6 | Jackups | 922 | 4,709 | 3,089 | |||||||||||||||||
Other(3) | $ | 26.5 | $ | 108.7 | $ | 115.3 | $ | 250.5 | Other(3) | 600 | 3,580 | 3,361 | |||||||||||||||||
| Total | $ | 268.3 | $ | 1,692.4 | $ | 1,197.4 | $ | 3,158.1 | Total | 2,127 | 11,847 | 8,414 | |||||||||||||||||
ARO Drilling(4) | Average Day Rates(1) (2) | 2023 | 2024 | 2025+ | |||||||||||||||||||||||||
| Owned Rigs | $ | 50.2 | $ | 357.1 | $ | 1,139.7 | $ | 1,547.0 | Drillships | $ | 261,000 | $ | 324,000 | $ | 389,000 | ||||||||||||||
| Leased Rigs | 46.0 | 345.4 | 352.3 | 743.7 | Semisubmersibles | 228,000 | 244,000 | 225,000 | |||||||||||||||||||||
| Total | $ | 96.2 | $ | 702.5 | $ | 1,492.0 | $ | 2,290.7 | Floaters | $ | 251,000 | $ | 306,000 | $ | 379,000 | ||||||||||||||
| HD - Ultra-Harsh & Harsh | $ | 111,000 | $ | 116,000 | $ | 137,000 | |||||||||||||||||||||||
| HD & SD - Modern | 91,000 | 104,000 | 122,000 | ||||||||||||||||||||||||||
| SD - Legacy | 74,000 | 80,000 | 88,000 | ||||||||||||||||||||||||||
| Jackups | $ | 97,000 | $ | 105,000 | $ | 109,000 | |||||||||||||||||||||||
(1) Contract backlog, contracted days and average day rates as of November 1, 2023. (2) Contract backlog and average day rates exclude certain types of non-recurring revenues such as lump sum mobilization payments. Contract backlog and contracted days include backlog and days when a rig is under suspension. Average day rates are adjusted to exclude suspension backlog and days. (3) Other represents contract backlog and contracted days related to bareboat charter agreements and management services contracts. (4) ARO Drilling contract backlog as of November 1, 2023. HD = Heavy Duty; SD = Standard Duty | |||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||

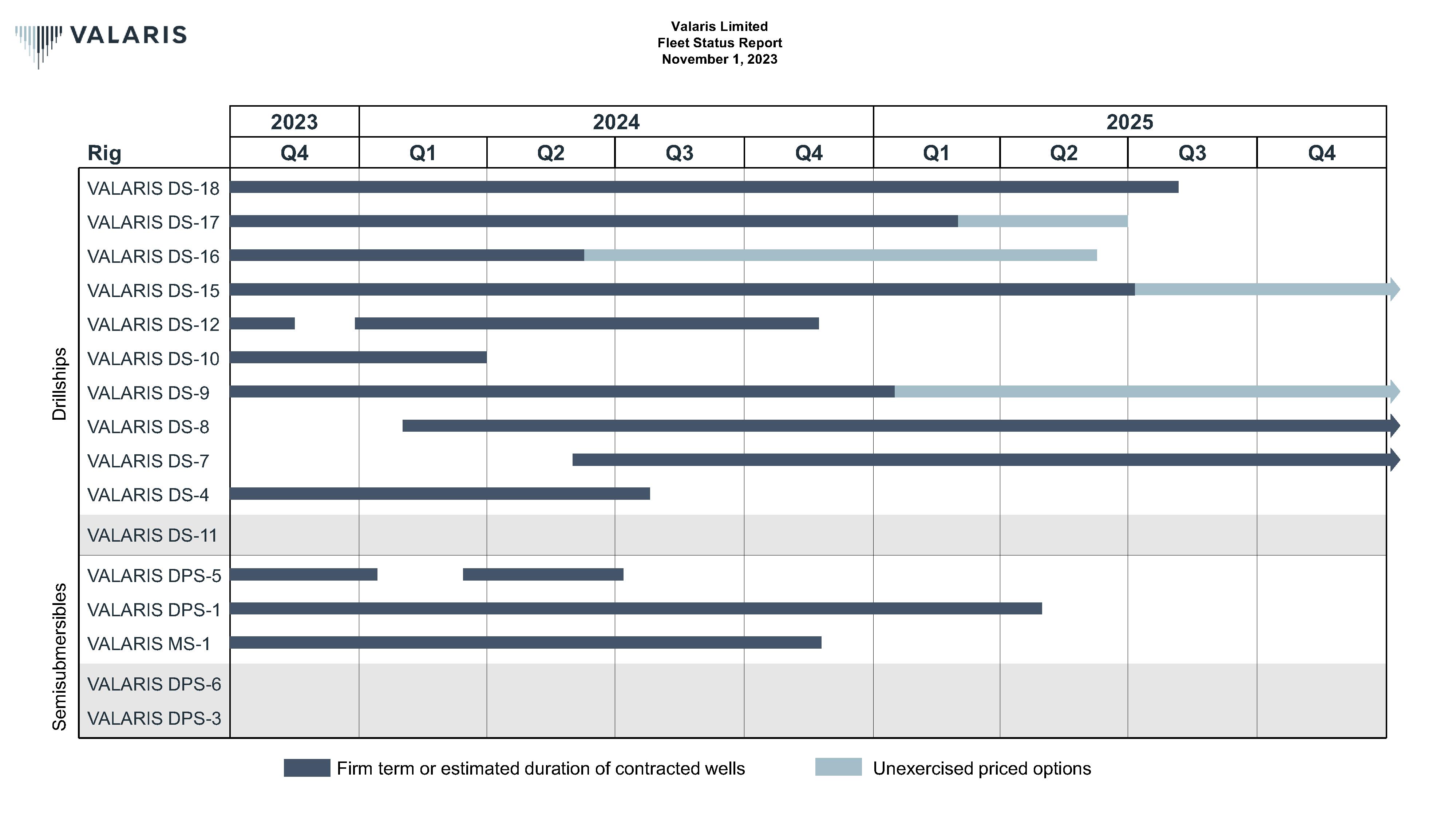

| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Drillships | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-18 | GustoMSC P10000 | 2015 | Chevron | U.S. GOM | Aug 22 | Aug 25 | Contract includes MPD services. Additional rate charged when MPD services provided. | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-17 | GustoMSC P10000 | 2014 | Equinor | Brazil | Sep 23 | Mar 25 | $447,000 | Contract includes MPD and additional services. Total contract value of $327 million, including an upfront payment of approx. $86 million for mobilization, capital upgrades and a contribution towards reactivation costs. Two priced options each with an estimated duration of 60 days | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-16 | GustoMSC P10000 | 2014 | Occidental | U.S. GOM | Jun 22 | Jun 24 | Contract includes MPD services. Additional rate charged when MPD services provided. 1-year priced option | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-15 | GustoMSC P10000 | 2014 | TotalEnergies BP TotalEnergies TotalEnergies | Brazil Brazil Brazil Brazil | Jun 21 Apr 24 Jul 24 Nov 24 | Mar 24 Jun 24 Oct 24 Jul 25 | $410,000 $254,000 $400,000 | Contract includes MPD services. Additional rate charged when MPD services provided. Additional rate charged when MPD and additional services provided. Two 160-day priced options and one 120-day priced option, with increased operating day rates for each option period. Total contract value for option periods if exercised, excluding the provision of MPD and additional services, is approximately $210 million | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-12 | DSME 12000 | 2014 | TotalEnergies BP | West Africa Egypt | Jul 23 Dec 23 | Nov 23 Nov 24 | Total contract value of $136 million | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-10 | Samsung GF12000 | 2017 | SNEPCo | Nigeria | Apr 23 | Mar 24 | $231,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-9 | Samsung GF12000 | 2015 | ExxonMobil | Angola | Jul 22 | Jan 25 | Contract includes MPD services. Three 6-month priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-8 | Samsung GF12000 | 2015 | Petrobras | Brazil | Feb 24 | Jan 27 | $428,000 | Plus mobilization fee of approx. $30 million. Contract includes additional services. Rig departed shipyard in late October to mobilize to Brazil | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-7 | Samsung 96K | 2013 | Undisclosed | West Africa | Jun 24 | Sep 26 | Total contract value estimated to be $364 million. Estimated duration of 850 days. Rig being reactivated in Spain | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-4 | Samsung 96K | 2010 | Petrobras | Brazil | Jul 22 | Jul 24 | Contract includes MPD and additional services | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-11 | DSME 12000 | 2013 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
Purchase Options(3) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-14 | DSME 12000 | South Korea | Option to take delivery by year-end 2023. Purchase price of approx. $218 million assuming a Dec 31, 2023 delivery | |||||||||||||||||||||||||||||||||||||||||||||||
VALARIS DS-13 | DSME 12000 | South Korea | Option to take delivery by year-end 2023. Purchase price of approx. $119 million assuming a Dec 31, 2023 delivery | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Semisubmersibles | ||||||||||||||||||||||||||||||||||||||||||||||||||
VALARIS DPS-5 | ENSCO 8500 Series, DP + Moored | 2012 | Eni Occidental Apache Eni | Mexico U.S. GOM U.S. GOM Mexico | Jan 23 Aug 23 Nov 23 Mar 24 | Jul 23 Nov 23 Jan 24 Jul 24 | $314,000 $345,000 | Plus mobilization fee of approx. $1.2 million Plus $3 million mobilization fee | ||||||||||||||||||||||||||||||||||||||||||
VALARIS DPS-1 | F&G ExD Millennium, DP | 2012 | Woodside | Australia | Apr 22 Nov 23 | Oct 23 Apr 25 | ||||||||||||||||||||||||||||||||||||||||||||
VALARIS MS-1 | F&G ExD Millennium, Moored | 2011 | Santos Undisclosed | Australia Australia | Jul 22 Jan 24 | Dec 23 Nov 24 | Contract suspended. During the contract suspension period, the duration of which is currently unknown, we do not expect a material impact on revenues and earnings. Three priced options each with an estimated duration of 30 days | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DPS-6 | ENSCO 8500 Series, DP | 2012 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DPS-3 | ENSCO 8500 Series, DP + Moored | 2010 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||

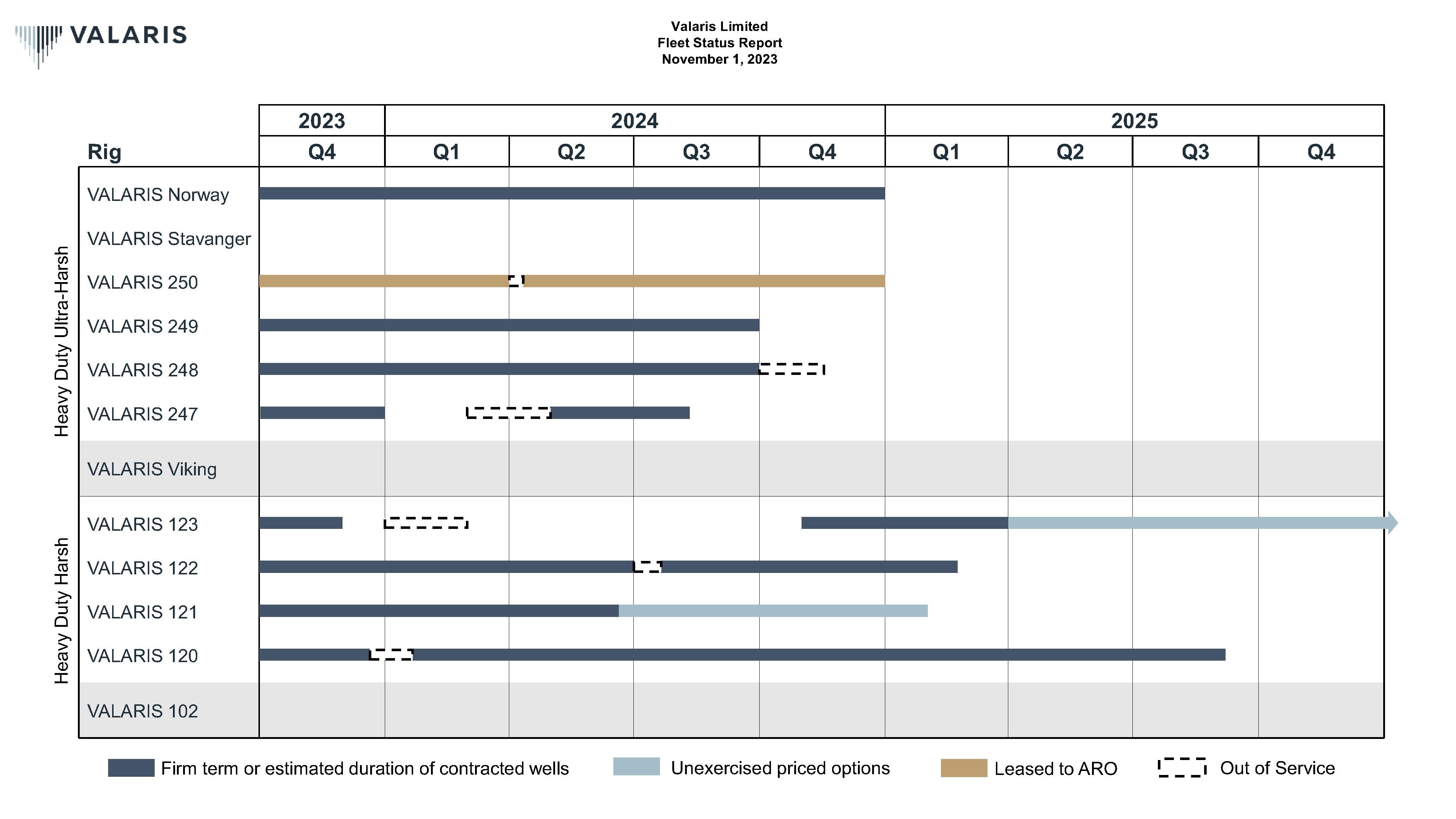

Heavy Duty Ultra-Harsh Environment(4) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Norway | KFELS N Class | 2011 | NEO Energy North Sea Natural Resources Eni | UK UK UK | Aug 23 Oct 23 Dec 23 | Oct 23 Dec 23 Dec 24 | $105,000 $105,000 $85,000 | VALARIS Norway substitutes for VALARIS 72 until the rig completes its current contract | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS Stavanger | KFELS N Class | 2011 | UK | Warm stacked | ||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 250 | LT Super Gorilla XL | 2003 | Saudi Aramco | Saudi Arabia | Jun 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 10 days out of service for planned maintenance in 2Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 249 | LT Super Gorilla | 2002 | Undisclosed Perenco | Trinidad Trinidad | Jul 23 Aug 24 | Jul 24 Sep 24 | $125,000 | Plus mobilization fee of $8.5 million and a daily rate of $64,000 while the rig was in transit from New Zealand to Trinidad | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 248 | LT Super Gorilla | 2000 | Neptune | UK | Aug 20 | Sep 24 | Expect approx. 45 days out of service for planned maintenance in 4Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 247 | LT Super Gorilla | 1998 | Perenco Undisclosed | UK Australia | Mar 23 May 24 | Dec 23 Aug 24 | $180,000 | Plus mobilization and demobilization fees that cover moving and operating costs while the rig is in transit. Expect approx. 60 days out of service for contract preparations across 1Q24 and 2Q24 | ||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Viking | KFELS N Class | 2010 | UK | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
Heavy Duty Harsh Environment(4) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 123 | KFELS Super A | 2019 | ONE-Dyas TAQA TAQA | Netherlands Netherlands Netherlands | Mar 23 Nov 24 Jan 25 | Nov 23 Dec 24 Mar 25 | $143,000 $153,000 | Expect approx. 60 days out of service for planned maintenance in 1Q24 Plus options for up to 10 wells with an estimated total duration of 300 days. Operating day rate increases to approx. $163,000 in 2026 | ||||||||||||||||||||||||||||||||||||||||||
VALARIS 122 | KFELS Super A | 2014 | Shell | UK | Sep 23 | Feb 25 | Total contract value of over $60 million based on estimated duration of 500 days. Expect approx. 20 days out of service for planned maintenance in 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 121 | KFELS Super A | 2013 | Petrofac Shell | UK UK | Jul 23 Nov 23 | Nov 23 Jun 24 | Total contract value of over $25 million. Four priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 120 | KFELS Super A | 2013 | Harbour Energy | UK | Jul 17 Jul 23 | Jul 23 Sep 25 | $130,000 | Expect approx. 30 days out of service for planned maintenance across 4Q23 and 1Q24 | ||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 102 | KFELS MOD V-A | 2002 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||

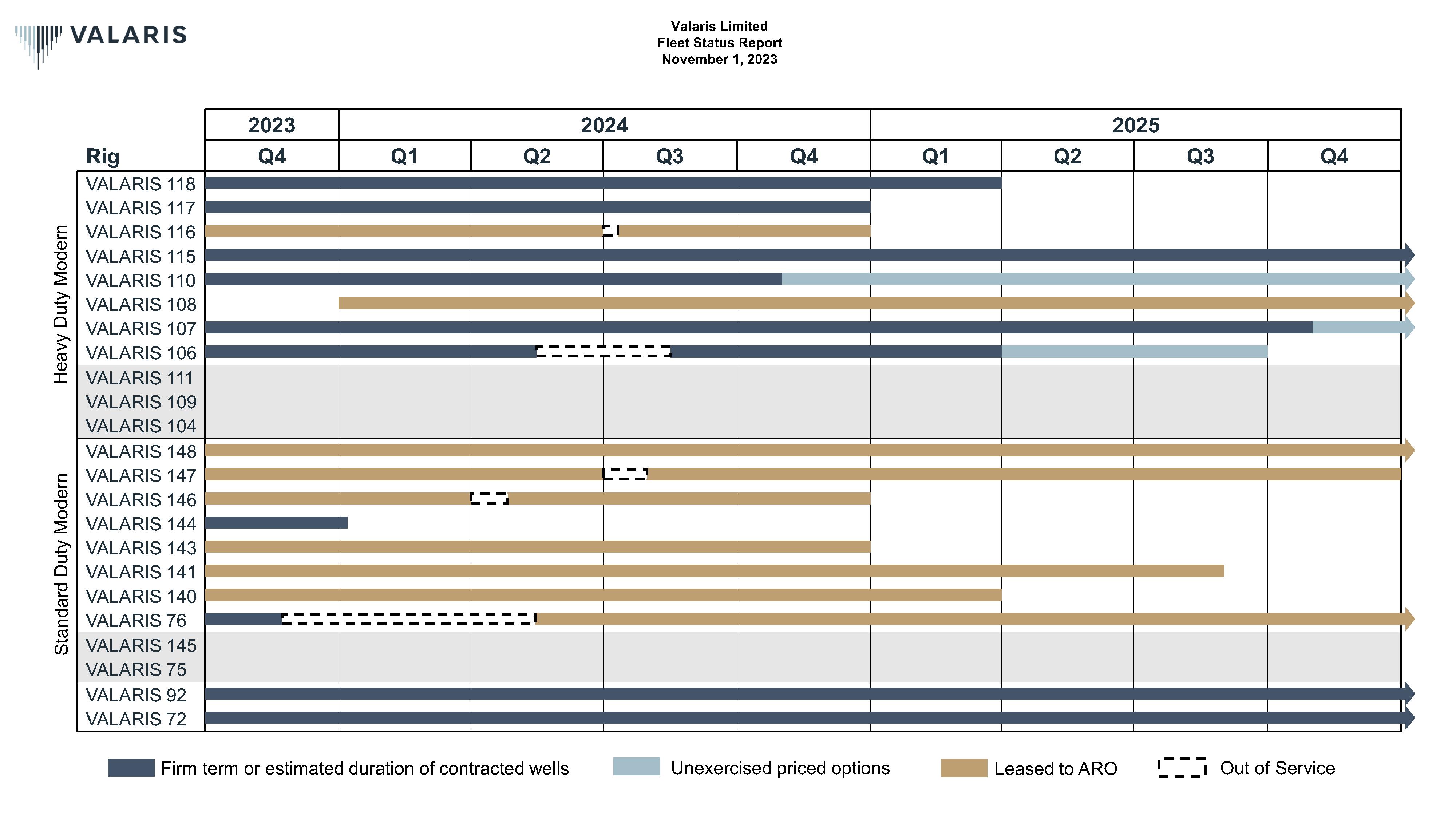

| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
Heavy Duty - Modern(4) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 118 | LT 240-C | 2011 | BP BP | Trinidad Trinidad | Jul 23 Mar 24 | Mar 24 Mar 25 | Total contract value of approx. $24 million Total contract value of approx. $51 million | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 117 | LT 240-C | 2009 | Eni | Mexico | Dec 21 | Dec 24 | ||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 116 | LT 240-C | 2008 | Saudi Aramco | Saudi Arabia | Dec 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 10 days out of service for planned maintenance in 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 115 | BM Pacific Class 400 | 2013 | Shell | Brunei | Apr 23 | Apr 27 | Total contract value of approx. $159 million | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 110 | KFELS MOD V-B | 2015 | North Oil Company | Qatar | Oct 21 | Oct 24 | Two 1-year priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 108 | KFELS MOD V-B | 2007 | Saudi Aramco | Saudi Arabia | Jan 24 | Dec 26 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 107 | KFELS MOD V-B | 2006 | GB Energy Beach Energy Undisclosed Undisclosed ExxonMobil | Australia New Zealand Australia Australia Australia | May 23 Oct 23 Jan 24 Mar 24 Oct 24 | Jul 23 Jan 24 Feb 24 Sep 24 Oct 25 | $118,000 $120,000 $150,000 $153,000 | Total contract value of approx. $26 million, including mobilization and demobilization fee Two 180-day priced options | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 106 | KFELS MOD V-B | 2005 | BP BP BP | Indonesia Indonesia Indonesia | Jan 18 Jan 24 Jan 25 | Jan 24 Jan 25 Mar 25 | $85,000 $95,000 | Two priced options each with an estimated duration of 90 days. Expect approx. 90 days out of service for planned maintenance across 2Q24 and 3Q24 | ||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 111 | KFELS MOD V-B | 2003 | Croatia | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 109 | KFELS MOD V-Super B | 2008 | Namibia | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 104 | KFELS MOD V-B | 2002 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Standard Duty - Modern | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 148 | LT Super 116-E | 2013 | Saudi Aramco | Saudi Arabia | Nov 19 | Feb 26 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 147 | LT Super 116-E | 2013 | Saudi Aramco | Saudi Arabia | Sep 19 | Dec 25 | Leased to ARO Drilling(5). Expect approx. 30 days out of service for planned maintenance in 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 146 | LT Super 116-E | 2011 | Saudi Aramco | Saudi Arabia | Sep 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 25 days out of service for planned maintenance in 2Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 144 | LT Super 116-E | 2010 | Cantium Talos | U.S. GOM U.S. GOM | Apr 23 Nov 23 | Nov 23 Jan 24 | $85,000 $87,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 143 | LT Super 116-E | 2010 | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 24 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 141 | LT Super 116-E | 2016 | Saudi Aramco | Saudi Arabia | Aug 22 | Aug 25 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 140 | LT Super 116-E | 2016 | Saudi Aramco | Saudi Arabia | Mar 22 | Mar 25 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 76 | LT Super 116-C | 2000 | Saudi Aramco | Saudi Arabia | Jan 15 May 24 | Nov 23 May 29 | Expect approx. 170 days out of service for contract preparations across 4Q23, 1Q24 and 2Q24. Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 145 | LT Super 116-E | 2010 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 75 | LT Super 116-C | 1999 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Standard Duty - Legacy | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 92 | LT 116-C | 1982 | Harbour Energy | UK | Feb 17 Mar 24 | Feb 24 Feb 26 | $95,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 72 | Hitachi K1025N | 1981 | Eni Eni | UK UK | Jan 20 Jan 25 | Dec 24 Aug 27 | ||||||||||||||||||||||||||||||||||||||||||||
| Other | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Drilling Management | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Thunder Horse | Deepwater Semisubmersible | BP | U.S. GOM | Jan 17 | Jan 24 | |||||||||||||||||||||||||||||||||||||||||||||
| Mad Dog | Deepwater Spar Drilling Rig | BP | U.S. GOM | Jan 17 | Jan 24 | |||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | |||||||||||||||||||||||||||||||||||||
| ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| Jackup Rigs Owned by ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| ARO 2001 | LT 116-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 2003 | BM 200-H | Saudi Aramco | Saudi Arabia | Feb 18 | Feb 26 | Expect approx. 45 days out of service for planned maintenance in 1Q24 | ||||||||||||||||||||||||||||||||||||||
| ARO 3001 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 3002 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | Expect approx. 75 days out of service for planned maintenance across 1Q24 and 2Q24 | ||||||||||||||||||||||||||||||||||||||
| ARO 3003 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | Expect approx. 15 days out of service for planned maintenance in 2Q24 | ||||||||||||||||||||||||||||||||||||||
| ARO 3004 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 4001 | KFELS Super B | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| Kingdom 1 | LT 116-C | Saudi Aramco | Saudi Arabia | Nov 23 | Nov 31 | |||||||||||||||||||||||||||||||||||||||
| Kingdom 2 | LT 116-C | Saudi Aramco | Saudi Arabia | Mar 24 | Mar 32 | Under construction. Delivery expected in 1Q24 | ||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
Out of Service Days (1) | ||||||||||||||||||||||||||||||||||||||||||||
| Rig | Asset Category | Q4 2023 | Q1 2024 | Q2 2024 | Q3 2024 | Q4 2024 | FY 2024 | |||||||||||||||||||||||||||||||||||||
| VALARIS 250 | Jackup - Heavy Duty Ultra-Harsh Environment (Leased to ARO Drilling) | 10 | 10 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 248 | Jackup - Heavy Duty Ultra-Harsh Environment | 45 | 45 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 247 | Jackup - Heavy Duty Ultra-Harsh Environment | 30 | 30 | 60 | ||||||||||||||||||||||||||||||||||||||||
| VALARIS 123 | Jackup - Heavy Duty Harsh Environment | 60 | 60 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 122 | Jackup - Heavy Duty Harsh Environment | 20 | 20 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 120 | Jackup - Heavy Duty Harsh Environment | 10 | 20 | 20 | ||||||||||||||||||||||||||||||||||||||||
| VALARIS 116 | Jackup - Heavy Duty Modern (Leased to ARO Drilling) | 10 | 10 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 106 | Jackup - Heavy Duty Modern | 30 | 60 | 90 | ||||||||||||||||||||||||||||||||||||||||
| VALARIS 147 | Jackup - Standard Duty Modern (Leased to ARO Drilling) | 30 | 30 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 146 | Jackup - Standard Duty Modern (Leased to ARO Drilling) | 25 | 25 | |||||||||||||||||||||||||||||||||||||||||
| VALARIS 76 | Jackup - Standard Duty Modern (Leased to ARO Drilling) | 40 | 90 | 40 | 130 | |||||||||||||||||||||||||||||||||||||||




![]() | Valaris Limited Fleet Status Report November 1, 2023 | |||||||||||||
