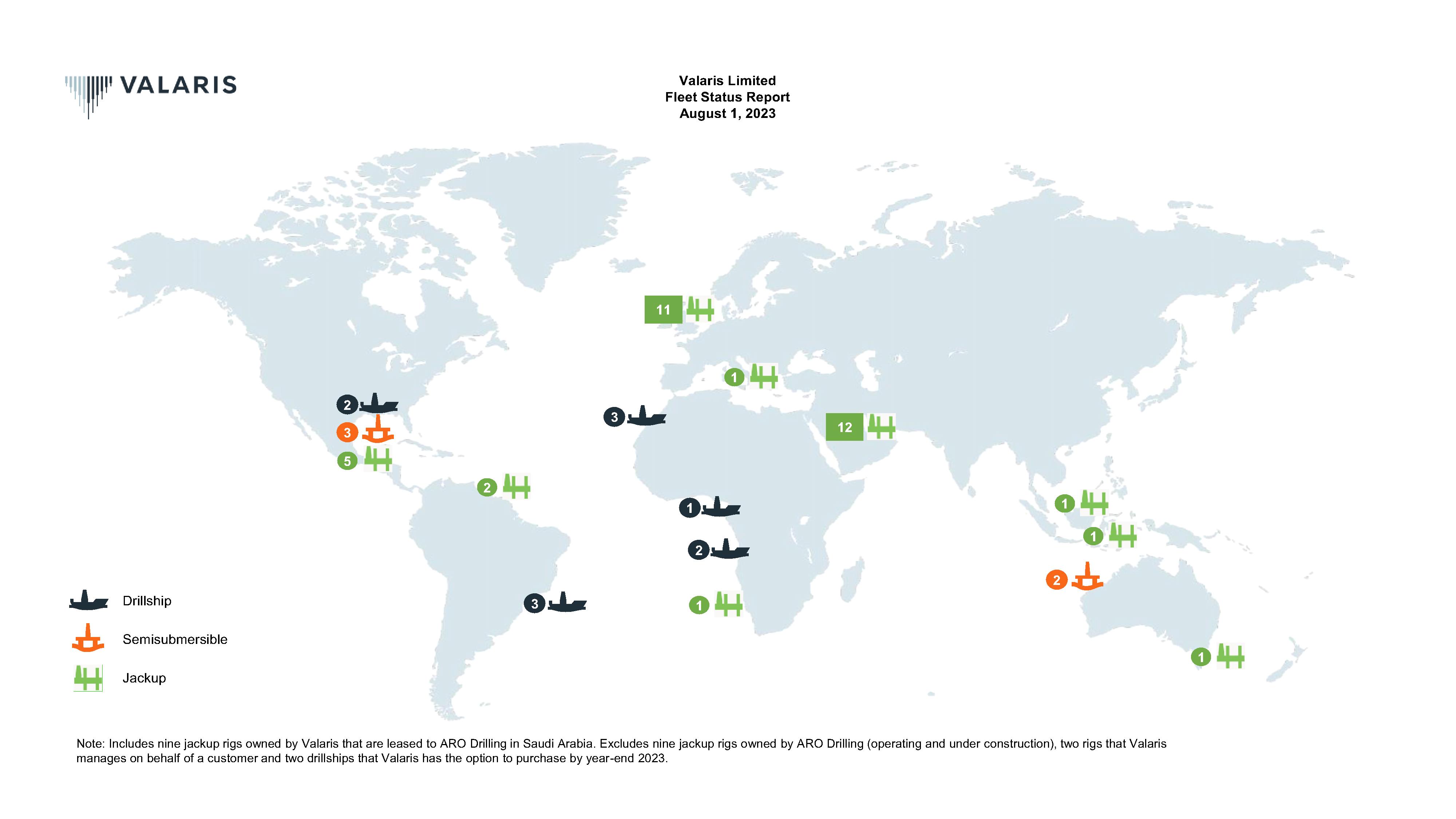

![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| New Contracts and Extensions, Rig Sales and Other Updates Since Last Fleet Status Report | ||
Floaters •12-well contract offshore West Africa for drillship VALARIS DS-7, which will be reactivated for this contract. The contract is expected to commence in second quarter 2024 and has an estimated duration of 850 days. The total contract value is estimated to be $364 million. The contract requires minimal customer-specific upgrades to the rig and does not include the provision of any additional services. •Two-well contract with Anadarko Petroleum Corporation (a wholly owned subsidiary of Occidental) in the U.S. Gulf of Mexico for semisubmersible Valaris DPS-5. The contract is expected to commence in August 2023 and has a minimum duration of 60 days. •Nine-well contract for a plug and abandonment campaign with Apache in the U.S. Gulf of Mexico for semisubmersible VALARIS DPS-5. The contract is expected to commence in October 2023 and has a minimum duration of 110 days. Jackups •180-day (minimum duration) contract with an undisclosed operator offshore Australia for heavy duty modern jackup VALARIS 107. The contract is expected to commence in first quarter 2024. The operating day rate is $150,000. •One-year contract with Esso Australia Pty. Ltd for heavy duty modern jackup VALARIS 107. The contract is expected to commence in October 2024. •Two-well contract with a major Australian operator for heavy duty ultra-harsh environment jackup VALARIS 247. The contract is expected to commence in early to mid-2024 and has an estimated duration of 100 days. The operating day rate is $180,000 and Valaris will receive a mobilization and demobilization fee that covers operating costs while the rig is in transit. | ||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
Contract Backlog(1) (2) ($ millions) | 2023 | 2024 | 2025+ | Total | Contracted Days(1) (2) | 2023 | 2024 | 2025+ | |||||||||||||||||||||
| Drillships | $ | 300.4 | $ | 741.7 | $ | 642.8 | $ | 1,684.9 | Drillships | 1,142 | 2,189 | 1,655 | |||||||||||||||||
| Semisubmersibles | 115.0 | 144.1 | 13.3 | 272.4 | Semisubmersibles | 459 | 627 | 59 | |||||||||||||||||||||
| Floaters | $ | 415.4 | $ | 885.8 | $ | 656.1 | $ | 1,957.3 | Floaters | 1,601 | 2,816 | 1,714 | |||||||||||||||||
| HD - Ultra-Harsh & Harsh | $ | 110.1 | $ | 163.0 | $ | 34.3 | $ | 307.4 | HD - Ultra-Harsh & Harsh | 985 | 1,314 | 264 | |||||||||||||||||
| HD & SD - Modern | 101.0 | 129.4 | 136.4 | 366.8 | HD & SD - Modern | 1,107 | 1,304 | 1,115 | |||||||||||||||||||||
| SD - Legacy | 21.3 | 56.9 | 40.2 | 118.4 | SD - Legacy | 283 | 716 | 423 | |||||||||||||||||||||
| Jackups | $ | 232.4 | $ | 349.3 | $ | 210.9 | $ | 792.6 | Jackups | 2,375 | 3,334 | 1,802 | |||||||||||||||||
Other(3) | $ | 72.5 | $ | 112.0 | $ | 106.9 | $ | 291.4 | Other(3) | 1,673 | 3,669 | 3,128 | |||||||||||||||||
| Total | $ | 720.3 | $ | 1,347.1 | $ | 973.9 | $ | 3,041.3 | Total | 5,649 | 9,819 | 6,644 | |||||||||||||||||
ARO Drilling(4) | Average Day Rates(1) (2) | 2023 | 2024 | 2025+ | |||||||||||||||||||||||||
| Owned Rigs | $ | 103.4 | $ | 246.6 | $ | 336.3 | $ | 686.3 | Drillships | $ | 263,000 | $ | 339,000 | $ | 388,000 | ||||||||||||||
| Leased Rigs | 130.0 | 352.2 | 332.8 | 815.0 | Semisubmersibles | 250,000 | 230,000 | 225,000 | |||||||||||||||||||||
| Total | $ | 233.4 | $ | 598.8 | $ | 669.1 | $ | 1,501.3 | Floaters | $ | 259,000 | $ | 315,000 | $ | 383,000 | ||||||||||||||
| HD - Ultra-Harsh & Harsh | $ | 112,000 | $ | 124,000 | $ | 130,000 | |||||||||||||||||||||||
| HD & SD - Modern | 91,000 | 99,000 | 122,000 | ||||||||||||||||||||||||||
| SD - Legacy | 75,000 | 79,000 | 95,000 | ||||||||||||||||||||||||||
| Jackups | $ | 98,000 | $ | 105,000 | $ | 117,000 | |||||||||||||||||||||||
(1) Contract backlog, contracted days and average day rates as of August 1, 2023. (2) Contract backlog and average day rates exclude certain types of non-recurring revenues such as lump sum mobilization payments. Contract backlog and contracted days include backlog and days when a rig is under suspension. Average day rates are adjusted to exclude suspension backlog and days. (3) Other represents contract backlog and contracted days related to bareboat charter agreements and management services contracts. (4) ARO Drilling contract backlog as of August 1, 2023. HD = Heavy Duty; SD = Standard Duty | |||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||

| Drillships | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-18 | GustoMSC P10000 | 2015 | Chevron | U.S. GOM | Aug 22 | Jul 25 | Contract includes MPD services. Additional rate charged when MPD services provided. | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-17 | GustoMSC P10000 | 2014 | Equinor | Brazil | Aug 23 | Feb 25 | $447,000 | Contract includes MPD and additional services. Total contract value of $327 million, including an upfront payment of approx. $86 million for mobilization, capital upgrades and a contribution towards reactivation costs. Two priced options each with an estimated duration of 60 days | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-16 | GustoMSC P10000 | 2014 | Occidental | U.S. GOM | May 22 | May 24 | Contract includes MPD services. Additional rate charged when MPD services provided. 1-year priced option | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-15 | GustoMSC P10000 | 2014 | TotalEnergies | Brazil | Jun 21 Feb 24 | Feb 24 May 24 | $254,000 | Contract includes MPD services. Additional rate charged when MPD services provided. | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-12 | DSME 12000 | 2014 | Undisclosed TotalEnergies BP | Angola West Africa Egypt | Mar 23 Jul 23 Dec 23 | Jun 23 Oct 23 Nov 24 | Total contract value of $26 million Total contract value of $136 million | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-10 | Samsung GF12000 | 2017 | SNEPCo | Nigeria | Apr 23 | Mar 24 | $231,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-9 | Samsung GF12000 | 2015 | ExxonMobil | Angola | Jul 22 | Jul 24 | Contract includes MPD services. Four 6-month priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-8 | Samsung GF12000 | 2015 | Petrobras | Brazil | Feb 24 | Jan 27 | $428,000 | Plus mobilization fee of approx. $30 million. Contract includes additional services. Rig being reactivated in Spain and is expected to mobilize to Brazil in mid 4Q23 | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-7 | Samsung 96K | 2013 | Undisclosed | West Africa | Jun 24 | Sep 26 | Total contract value estimated to be $364 million. Estimated duration of 850 days. Rig being reactivated in Spain | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-4 | Samsung 96K | 2010 | Petrobras | Brazil | Jul 22 | Dec 23 | Contract includes MPD and additional services. 6-month priced option | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-11 | DSME 12000 | 2013 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
Purchase Options(3) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-14 | DSME 12000 | South Korea | Option to take delivery by year-end 2023. Purchase price of approx. $218 million assuming a Dec 31, 2023 delivery | |||||||||||||||||||||||||||||||||||||||||||||||
VALARIS DS-13 | DSME 12000 | South Korea | Option to take delivery by year-end 2023. Purchase price of approx. $119 million assuming a Dec 31, 2023 delivery | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Semisubmersibles | ||||||||||||||||||||||||||||||||||||||||||||||||||
VALARIS DPS-5 | ENSCO 8500 Series, DP + Moored | 2012 | Eni Occidental Apache | Mexico U.S. GOM U.S. GOM | Jan 23 Aug 23 Oct 23 | Jul 23 Oct 23 Jan 24 | $314,000 | Plus mobilization fee of approx. $1.2 million | ||||||||||||||||||||||||||||||||||||||||||
VALARIS DPS-1 | F&G ExD Millennium, DP | 2012 | Woodside | Australia | Apr 22 Sep 23 | Aug 23 Feb 25 | ||||||||||||||||||||||||||||||||||||||||||||
VALARIS MS-1 | F&G ExD Millennium, Moored | 2011 | Santos Undisclosed | Australia Australia | Jul 22 Oct 23 | Oct 23 Aug 24 | Contract suspended. During the contract suspension period, the duration of which is currently unknown, we do not expect a material impact on revenues and earnings. Three priced options each with an estimated duration of 30 days | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DPS-6 | ENSCO 8500 Series, DP | 2012 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DPS-3 | ENSCO 8500 Series, DP + Moored | 2010 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||

Heavy Duty Ultra-Harsh Environment(4) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Norway | KFELS N Class | 2011 | Centrica Storage NEO Energy North Sea Natural Resources | UK UK UK | Feb 23 Aug 23 Sep 23 | Jun 23 Sep 23 Oct 23 | $105,000 $105,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS Stavanger | KFELS N Class | 2011 | UK | Warm stacked | ||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 250 | LT Super Gorilla XL | 2003 | Saudi Aramco | Saudi Arabia | Jun 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 60 days out of service for planned maintenance across 1Q24 and 2Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 249 | LT Super Gorilla | 2002 | Undisclosed | Trinidad | Jul 23 | Jul 24 | $125,000 | Plus mobilization fee of $8.5 million and a daily rate of $64,000 while the rig was in transit from New Zealand to Trinidad | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 248 | LT Super Gorilla | 2000 | Neptune | UK | Aug 20 | Jun 24 | Expect approx. 45 days out of service for planned maintenance in 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 247 | LT Super Gorilla | 1998 | Perenco Undisclosed | UK Australia | Mar 23 Mar 24 | Nov 23 Jun 24 | $180,000 | Plus mobilization and demobilization fees that cover moving and operating costs while the rig is in transit | ||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Viking | KFELS N Class | 2010 | UK | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
Heavy Duty Harsh Environment(4) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 123 | KFELS Super A | 2019 | ONE-Dyas | Netherlands | Mar 23 | Oct 23 | Expect approx. 30 days out of service for planned maintenance in 2Q24 | |||||||||||||||||||||||||||||||||||||||||||
VALARIS 122 | KFELS Super A | 2014 | Shell | UK | Nov 22 Sep 23 | Aug 23 Jan 25 | Total contract value of over $60 million based on estimated duration of 500 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 121 | KFELS Super A | 2013 | Petrofac Shell | UK UK | Jul 23 Oct 23 | Sep 23 Apr 24 | Total contract value of over $25 million. Four priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 120 | KFELS Super A | 2013 | Harbour Energy | UK | Jul 17 Jul 23 | Jul 23 Sep 25 | $130,000 | Expect approx. 60 days out of service for planned maintenance in 2Q24 | ||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 102 | KFELS MOD V-A | 2002 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||

Heavy Duty - Modern(4) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 118 | LT 240-C | 2011 | BP | Trinidad | Oct 22 Jul 23 | Jun 23 Jan 24 | Total contract value of approx. $24 million. Expect approx. 15 days out of service for planned maintenance in 4Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 117 | LT 240-C | 2009 | Eni | Mexico | Dec 21 | Nov 24 | ||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 116 | LT 240-C | 2008 | Saudi Aramco | Saudi Arabia | Dec 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 40 days out of service for planned maintenance in 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 115 | BM Pacific Class 400 | 2013 | Shell | Brunei | Apr 23 | Apr 27 | Total contract value of approx. $159 million | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 110 | KFELS MOD V-B | 2015 | North Oil Company | Qatar | Oct 21 | Oct 24 | Two 1-year priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 108 | KFELS MOD V-B | 2007 | Saudi Aramco | Saudi Arabia | Aug 23 | Aug 26 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 107 | KFELS MOD V-B | 2006 | Eni GB Energy Beach Energy Undisclosed Undisclosed ExxonMobil | Australia Australia New Zealand Australia Australia Australia | Mar 23 May 23 Aug 23 Jan 24 Mar 24 Oct 24 | May 23 Jul 23 Dec 23 Feb 24 Sep 24 Oct 25 | $127,000 $118,000 $120,000 $150,000 $153,000 | Total contract value of approx. $26 million, including mobilization and demobilization fee Two 180-day priced options | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 106 | KFELS MOD V-B | 2005 | BP | Indonesia | Jan 18 | Jan 24 | Seven priced options each with an estimated duration of 90 days. Expect approx. 90 days out of service for planned maintenance across 2Q24 and 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 111 | KFELS MOD V-B | 2003 | Croatia | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 109 | KFELS MOD V-Super B | 2008 | Namibia | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 104 | KFELS MOD V-B | 2002 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Standard Duty - Modern | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 148 | LT Super 116-E | 2013 | Saudi Aramco | Saudi Arabia | Nov 19 | Feb 26 | Leased to ARO Drilling(5). Expect approx. 40 days out of service for planned maintenance in 2Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 147 | LT Super 116-E | 2013 | Saudi Aramco | Saudi Arabia | Sep 19 | Dec 25 | Leased to ARO Drilling(5). Expect approx. 50 days out of service for planned maintenance in 1Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 146 | LT Super 116-E | 2011 | Saudi Aramco | Saudi Arabia | Sep 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 40 days out of service for planned maintenance in 2Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 144 | LT Super 116-E | 2010 | Cantium Talos | U.S. GOM U.S. GOM | Apr 23 Oct 23 | Oct 23 Jan 24 | $85,000 $87,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 143 | LT Super 116-E | 2010 | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 24 | Leased to ARO Drilling(5). Expect approx. 15 days out of service for planned maintenance in 3Q24 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 141 | LT Super 116-E | 2016 | Saudi Aramco | Saudi Arabia | Aug 22 | Aug 25 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 140 | LT Super 116-E | 2016 | Saudi Aramco | Saudi Arabia | Mar 22 | Mar 25 | Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 76 | LT Super 116-C | 2000 | Saudi Aramco | Saudi Arabia | Jan 15 Feb 24 | Oct 23 Feb 29 | Expect approx. 100 days out of service for contract preparations across 4Q23 and 1Q24. Leased to ARO Drilling(5) | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 145 | LT Super 116-E | 2010 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 75 | LT Super 116-C | 1999 | U.S. GOM | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Standard Duty - Legacy | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 92 | LT 116-C | 1982 | Harbour Energy | UK | Feb 17 Mar 24 | Feb 24 Feb 26 | $95,000 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 72 | Hitachi K1025N | 1981 | Eni | UK | Jan 20 | Dec 24 | Expect approx. 55 days out of service for planned maintenance in 3Q23 | |||||||||||||||||||||||||||||||||||||||||||
| Other | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Drilling Management | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Thunder Horse | Deepwater Semisubmersible | BP | U.S. GOM | Jan 17 | Jan 24 | |||||||||||||||||||||||||||||||||||||||||||||
| Mad Dog | Deepwater Spar Drilling Rig | BP | U.S. GOM | Jan 17 | Jan 24 | |||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 1, 2023 | |||||||||||||
| Asset Category / Rig | Design | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | |||||||||||||||||||||||||||||||||||||
| ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| Jackup Rigs Owned by ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| ARO 2001 | LT 116-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 2003 | BM 200-H | Saudi Aramco | Saudi Arabia | Feb 18 | Feb 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 3001 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 3002 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 3003 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 3004 | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 4001 | KFELS Super B | Saudi Aramco | Saudi Arabia | Oct 17 | Jan 26 | |||||||||||||||||||||||||||||||||||||||
| ARO 2005 | LT 116-C | Saudi Arabia | Under construction. Delivery expected in 2023 | |||||||||||||||||||||||||||||||||||||||||
| ARO 2006 | LT 116-C | Saudi Arabia | Under construction. Delivery expected in 2023 | |||||||||||||||||||||||||||||||||||||||||
